Commercial Roofing Case Study · Arlington, VA

Silicone Roof Restoration Arlington Warehouse 2330 Columbia Pike, Arlington, VA

Warehouse 7,306 SF

Years of leaking had rotted the wood structure along 50 feet of this warehouse's gutter line until the roof edge curled upward and dammed the water it was supposed to drain. The structure was rebuilt, the slope corrected, and the whole 7,306-square-foot modified bitumen roof restored with Progressive Materials high-solids silicone at 40 mils dry film thickness.

Project at a Glance

Project Ref GTR-2330Colum · Verified 09/2026
Building Type
Warehouse
Location
2330 Columbia Pike, Arlington, VA 22204
Roof Area
7,306 SF
Existing System
Modified bitumen, 30 years old
Deck Type
Wood deck
Installed System
Fluid-applied high-solids silicone restoration
Manufacturer
Progressive Materials
Field Coating
PM Pro-Eco Silicone HS 3200 Series
Coating Color
White (HS 3201 / LS 2201)
Dry Film Thickness
40 mils minimum DFT
Seam Treatment
20 mil silicone stripe, approx. 2 in. wide, all laps
Reinforced Repairs
3-course silicone and polyester at failed seams and flashings
Structural Repair
50 LF of rotted gutter-line decking and framing rebuilt
Slope Correction
Gutter-line slope re-established; PM Pro Slope at low areas
Surface Preparation
Power wash at minimum 2,000 PSI
Bleed-Block Primer
PM P-160, entire surface at 1 gal/100 SF
Diagnostics
Tramex surface scan and CMEX5 pin probe; HIKMICRO M30 post-sunset infrared scan
Warranty Issued
20-year Progressive Materials labor & material
Start Date
07/2026
Completion Date
09/2026
Duration
17 working days
Building Occupancy
In operation throughout; no tear-off
Recordable Incidents
0

Executive Summary

What This Project Involved

The roof on this Arlington warehouse was a 7,306-square-foot modified bitumen assembly draining to a gutter along one edge. The membrane across the field had weathered but was still sound enough to serve as a substrate. The problem was concentrated at the gutter line, and it was structural rather than a coating problem: prolonged leakage at the roof edge had kept the wood decking and framing beneath the membrane permanently wet, and the wood had swollen and rotted through.

As that structure deteriorated it lost its shape. The roof edge deflected and curled upward, forming a lip along the gutter line, and the lip acted as a dam. Water running down the roof reached the edge and stopped instead of spilling into the gutter, so it stood in a band along the very edge it was supposed to drain from. The condition was self-worsening: the standing water kept the rotting wood saturated, which let the edge rise further, which held back more water. Additional low areas elsewhere on the roof held water past 48 hours because the original slopes were inadequate.

Fifty linear feet of the gutter line was rebuilt. The membrane was opened, the rotted decking and framing were cut out and replaced with sound material, and the correct edge line and slope were re-established so water reaches the gutter instead of being dammed behind a lip. The rebuilt section was then reroofed and brought into the coating system. The moisture survey performed before restoration identified the remaining wet areas within the assembly, and those were cut out and replaced as well, so nothing saturated was sealed in beneath the new coating. Elsewhere, low areas were built back up with PM Pro Slope and alligatored and heavily cracked areas were filled and smoothed with PM SL 800 Surface Leveler.

With the structure and the drainage corrected, the roof was power washed at a minimum of 2,000 PSI, an adhesion test was performed on the cleaned and dried surface, and PM P-160 Asphalt Bleed-Block Primer was applied over the entire modified bitumen surface at one gallon per 100 square feet. Every membrane lap seam received a 20-mil silicone seam stripe approximately two inches wide, and failed and open seams and flashing failures were rebuilt with three-course silicone and polyester repairs. PM Pro-Eco Sil HS 3200 Series high-solids silicone was then applied in white to a minimum of 40 mils dry film thickness. Progressive Materials inspected the completed roof and issued a 20-year labor and material warranty covering leaks due to silicone material failure.

Starting Point

Existing Conditions

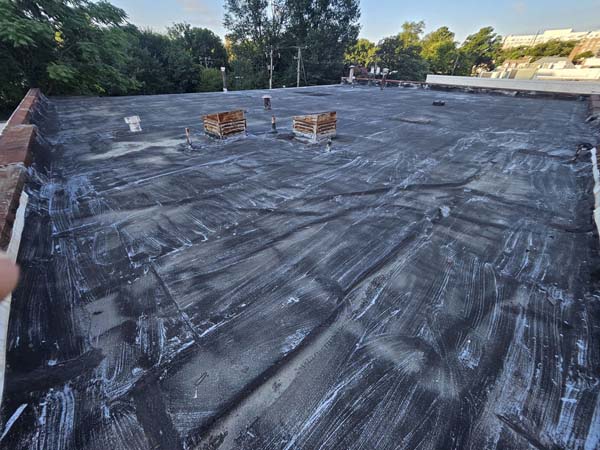

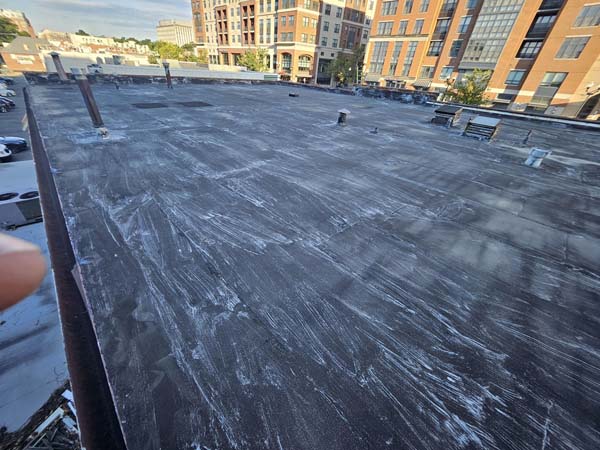

The field membrane was aged but serviceable as a substrate, which is what made this roof a restoration candidate. The failure was concentrated at the gutter line, where a long-running leak had destroyed the wood structure beneath the membrane and, in doing so, reversed the drainage the roof depended on. Conditions were recorded by component so the structural repair could be scoped separately from the coating work.

Documented deficiencies at survey
LocationObserved conditionExtentLeak history
Gutter-line structureWood decking and framing beneath the membrane swollen and rotted through from prolonged water exposure50 LF of roof edgeSevere long-term leakage at the roof edge
Roof edge profileDeteriorated structure had deflected upward, forming a lip that dammed water back onto the roof and blocked it from reaching the gutterAlong the same 50 LFStanding water held permanently against the edge
DrainagePonding held past 48 hours in low areas where the existing roof lacked positive slope to the gutter line9 ponding areas
Membrane fieldAged modified bitumen with surface weathering, granule loss, and areas of alligatoring and surface cracking7,306 SFReported leaks into the warehouse below
Membrane lap seamsWeathered laps with open and lifted edges at side and end joints3,760 LF of lap seamsSecondary entry points
Failed and open seamsSeams separated or split through, requiring reinforced repair rather than coating alone325 LFActive leakage
FlashingsFailed base flashing and open terminations at walls, curbs, and penetrations12 locationsReported at multiple locations

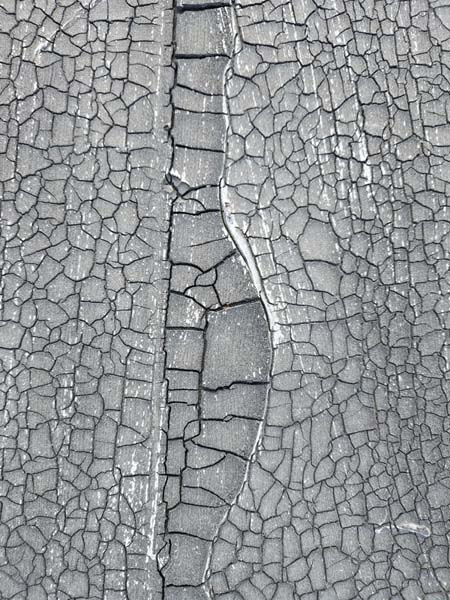

Alligatored areasHeavily cracked and alligatored asphalt surface requiring leveling before coating800 SF
Roof insulationRetained moisture within the assembly, mapped by survey prior to restoration300 SF wet, cut out and replacedAssociated with long-term leakage
PenetrationsAged sealant and failed detailing at pipe, vent, and conduit penetrations12 penetrationsReported at multiple penetrations

How We Know

Investigation & Diagnostics

Two questions had to be answered before this roof could be quoted as a restoration: how far the structural rot at the gutter line actually extended, and whether the rest of the assembly was dry enough to coat. Ponding at a roof edge is a symptom, and the survey was aimed at establishing its cause rather than recording its presence. The moisture survey and the post-cleaning adhesion test are both mandatory steps under the Progressive Materials warranted system.

Survey methods and findings
MethodInstrument / referenceFinding
Visual condition surveyWalk-over survey, NRCA inspection practiceDocumented weathering of the modified bitumen field, open and lifted laps, failed flashings, alligatored areas, and standing water held along the gutter line rather than draining into it
Roof edge and structural probeDirect probe and examination of the decking and framing at the gutter lineWood decking and framing found swollen and rotted through across 50 LF; the deterioration had allowed the edge to deflect upward and dam water back onto the roof
Moisture survey — surface scanTramex surface scan moisture meter, non-destructive, required by the manufacturer before restorationSwept the full roof area to map retained moisture within the existing assembly so wet material could be cut out and replaced instead of being sealed beneath the new coating

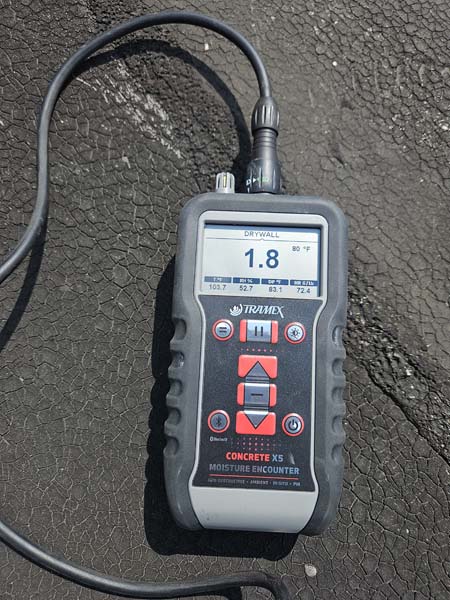

Moisture survey — pin probeTramex CMEX5 digital moisture meter with 2-pin probe, taken in 8 separate areas of the roofProvided direct penetrating readings to corroborate the surface scan and confirm the extent of moisture at the areas it flagged
Infrared thermographic scanHIKMICRO M30 Professional thermal imager, post-sunset scanLocated subsurface moisture by thermal signature as the roof released heat after sunset, independently corroborating the areas identified by the moisture meters

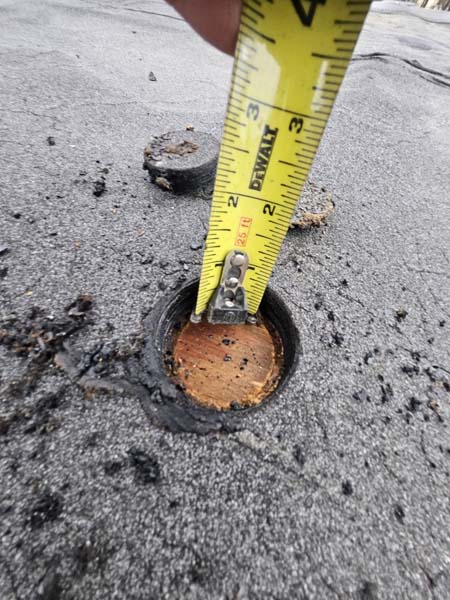

Core samplingFull-depth cores cut at flagged areas and patched the same dayConfirmed the existing assembly and verified the extent of the areas identified by the moisture survey and the thermographic scan
Adhesion testManufacturer-required adhesion test on the cleaned and dried surfacePass silicone bond to the washed modified bitumen surface confirmed before the field coating was committed
Drainage surveyPost-rainfall observation at 48 hoursConfirmed water was being held at the gutter line by the raised edge, and identified 9 further low areas for correction with PM Pro Slope
Seam and flashing surveyLap-by-lap inspection and probe of seam edges and flashing terminationsSeparated the laps that required only a standard seam stripe from the failed and open seams and flashing failures that required reinforced three-course repair

Decision Record

Options Evaluated

Continued repair, silicone restoration, single-ply recover, and full tear-off replacement were evaluated against the documented membrane condition, the extent of the structural damage at the gutter line, the moisture survey results, and the warranty available at the end of each. The decisive point was that the failure was localized and structural rather than a general failure of the membrane: once the 50 feet of rotted gutter-line structure was rebuilt and the slope re-established, the rest of the roof was a sound substrate for a warranted restoration.

Options presented to the owner
OptionEst. added service lifeTear-offDisruption to operationsWarranty availableOutcome
Continued spot repair1–3 yearsNoneRecurring leaks into the warehouseWorkmanship onlyNot selected
Coating without structural repairNot viablen/an/aNot available over rotted structureNot selected
Structural repair plus silicone restoration20 years, renewable at termLocalized at the gutter line and wet areas onlyMinimal; building stayed in operation20-year PM labor & materialSelected
Full tear-off replacement20–25 yearsFullHigh; open roof over stored goodsSingle-ply manufacturer NDLNot selected

Coating the roof without rebuilding the gutter line was rejected outright. A coating applied over rotted decking would have sealed the damage in, left the raised edge damming water exactly as before, and kept the wood wet under a new warranted system — and no manufacturer warranty would stand behind it. Restoration was viable here precisely because the structural defect was identified, isolated, and rebuilt first, at which point the remaining 7,306 SF of membrane was a sound base for a 20-year system without tearing off a roof over an operating warehouse.

What Was Installed

Specified System

The roof was installed to the Progressive Materials Modified Bitumen 20-Year System specification, preceded by the structural reconstruction the gutter line required. The 20-year term is not a function of the coating alone: it requires the prescribed surface preparation and testing, the prescribed repair details at every seam and flashing, a minimum 40 mils dry film thickness in the field, white coating only, and a manufacturer inspection of the completed roof before the warranty is issued. Our full silicone restoration process is described on our roof coatings page.

Structural repair and Progressive Materials 20-year system specification as installed
ComponentProduct / installed workSpecificationPurpose / result
Gutter-line reconstructionRotted wood decking and framing cut out and replaced with sound material50 LF of roof edge rebuiltRestored a structurally sound roof edge where prolonged leakage had destroyed the wood beneath the membrane
Edge slope correctionCorrect edge line and slope re-established across the rebuilt section, then reroofed into the existing membrane50 LFRemoved the raised lip that had been damming water and restored drainage into the gutter
Moisture surveyNon-destructive moisture survey of the full roof areaRequired before restorationLocated retained moisture so it could be removed rather than sealed beneath the coating

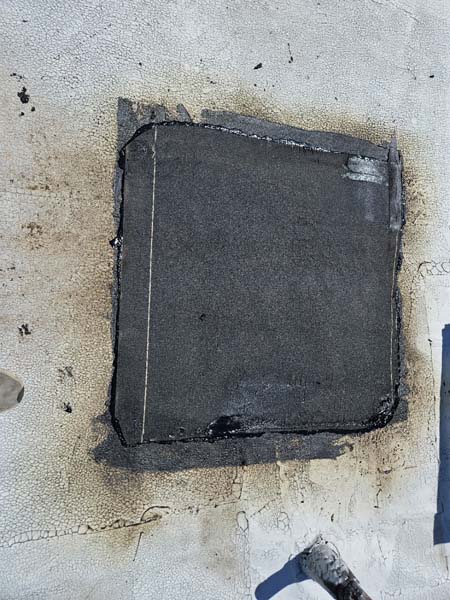

Wet insulation replacementSaturated areas cut out and replaced300 SF replaced to match existing R-valueRemoved the trapped moisture that would otherwise have blistered or disbonded the new system
Slope correctionPM Pro SlopeInstalled at remaining ponding and low areas as requiredRe-established positive drainage instead of carrying the ponding forward into the new system
Surface levelingPM SL 800 Surface LevelerApplied at alligatored and heavily cracked areas as requiredFilled and smoothed cracked asphalt so the coating had a sound, continuous surface to bond to
CleaningPower wash of the full roof areaMinimum 2,000 PSI, rinsed and driedRemoved contamination and weathered surface material so the silicone could bond

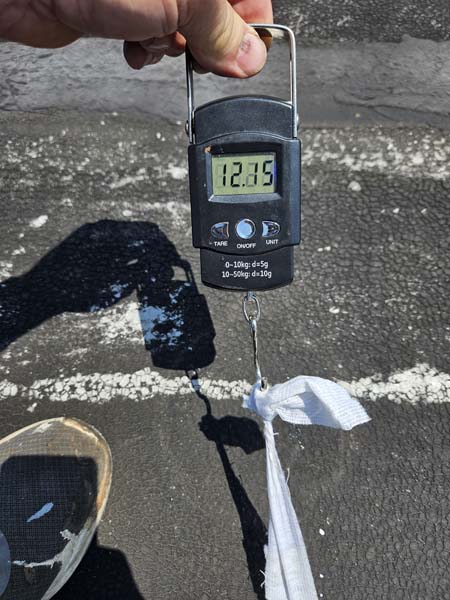

Adhesion testManufacturer-required adhesion testPerformed after cleaning and dryingConfirmed bond to this specific aged modified bitumen surface before full application
Bleed-block primerPM P-160 Asphalt Bleed-Block Primer — single-component, water-based, plasticizer-free acrylic1 gallon per 100 SF, spray applied over the entire modified bitumen surfaceFormed a barrier between the asphalt surface and the silicone, preventing chemicals bleeding out of the asphalt from yellowing the white coating
Seam stripe — all lap seamsSilicone seam stripe over every membrane lap seam20 mils, approx. 2 in. wide, approx. 400 LF per gallon, applied before field coatingBuilt additional thickness over the most vulnerable line on the roof ahead of the field coat
Failed and open seams3-course repair: silicone, polyester fabric, siliconeReinforced repair at every failed or open seamRestored tensile strength and bridging capability where the membrane had already split

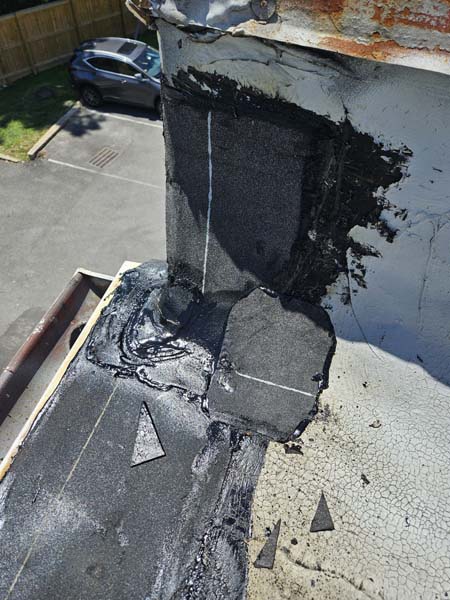

Flashing failures3-course repair: silicone, polyester fabric, siliconeSame reinforced detail at all flashing failuresRebuilt the wall, curb, and penetration transitions as part of the warranted system
Field coatingPM Pro-Eco Sil HS 3200 Series high-solids silicone40 mils minimum dry film thickness across the full 7,306 SFSeamless fluid-applied waterproofing layer over the restored substrate
Coating colorWhite — HS 3201 / LS 2201White only for the 20-year systemRequired color for the 20-year term; also delivers the reflectivity benefit of a cool roof
Final inspectionProgressive Materials manufacturer inspectionRequired for the warranted systemManufacturer verification of the completed roof before the warranty was issued
WarrantyProgressive Materials 20-year warranty20-year labor and material, covering leaks due to silicone material failureManufacturer-backed long-term coverage for the restored roof

How It Was Delivered

Execution

The structural work came first and the coating last. Because a restoration does not open the field membrane, the only areas exposed at any point were the localized gutter-line reconstruction and the wet areas being replaced, and each was dried in before the end of the shift so the warehouse below stayed protected.

  1. Preconstruction · Survey & testing

    Moisture survey and scope development

    The roof was surveyed and a non-destructive moisture survey was performed across the full area before any scope was priced, as the Progressive Materials system requires. The survey was run with a Tramex surface scan moisture meter across the roof field, backed up by a Tramex CMEX5 digital moisture meter using a 2-pin probe taken in eight separate areas of the roof. A post-sunset infrared thermographic scan with a HIKMICRO M30 Professional thermal imager was performed as a third, independent check, reading the areas of retained moisture by the heat they held after sunset. Cores were cut at the flagged areas and patched the same day. The gutter line was probed directly to establish how far the rot in the decking and framing actually ran, since that determined whether this roof was a restoration candidate at all.

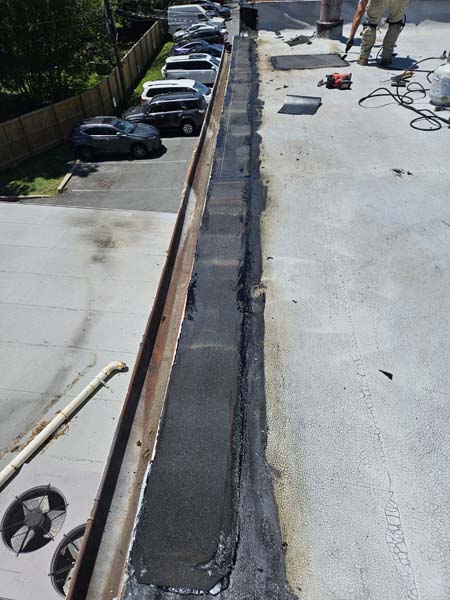

  2. 07/2026 · Structural repair

    Rebuilding 50 LF of the gutter line

    The membrane was opened along the affected roof edge and the swollen, rotted wood decking and framing were cut out and replaced with sound material across 50 linear feet. This was the root cause of the ponding, not a consequence of it: as the wood had rotted it had allowed the edge to deflect upward into a lip that dammed water back onto the roof and held it against the very structure it was destroying. With sound material in place the correct edge line and slope were re-established so water runs into the gutter, and the rebuilt section was reroofed and tied back into the existing membrane.

  3. 07/2026 · Repairs

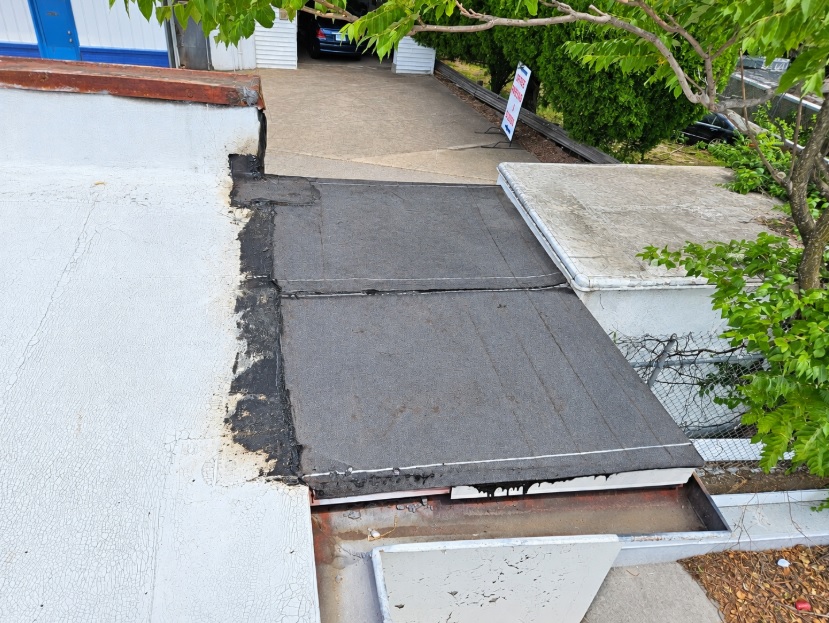

    Wet area replacement and slope correction

    The saturated areas identified by the moisture survey were cut out and replaced before any coating work began, so nothing wet was sealed in beneath the new system. Remaining low areas that had been holding water past 48 hours were built back up with PM Pro Slope and feathered out into the surrounding field to carry water toward the gutter line, and alligatored and heavily cracked areas were filled and smoothed with PM SL 800 Surface Leveler to give the silicone a sound, continuous surface.

  4. 07/2026–08/2026 · Preparation

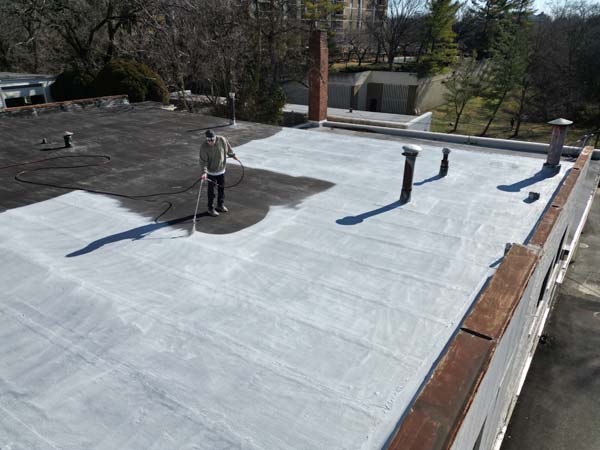

    Power washing, adhesion testing, and bleed-block primer

    The full roof area was power washed at a minimum of 2,000 PSI to remove contamination and weathered surface material, then rinsed and allowed to dry completely. With the surface clean and dry, the manufacturer-required adhesion test was performed to confirm the silicone would bond to this specific aged modified bitumen. PM P-160 Asphalt Bleed-Block Primer was then spray applied over the entire 7,306 square feet at one gallon per 100 square feet. P-160 is a single-component, water-based, plasticizer-free acrylic primer formulated for smooth asphalt roof surfaces; it forms a barrier between the asphalt and the silicone so the chemicals that bleed out of an asphalt roof cannot migrate up and yellow the white coating.

  5. 08/2026 · Seams & details

    Seam striping and three-course repairs

    Every membrane lap seam across the roof received a 20-mil silicone seam stripe approximately two inches wide, applied at roughly 400 linear feet per gallon, before any field coating was applied. Laps are where a modified bitumen roof moves and where water gets in first, so they were built up ahead of the field rather than being left at field thickness. Failed and open seams and every flashing failure were rebuilt with a three-course reinforced repair — a base layer of silicone, polyester reinforcing fabric embedded into it while wet, and a second layer of silicone encapsulating the fabric. Curbs, walls, and penetrations were detailed the same way.

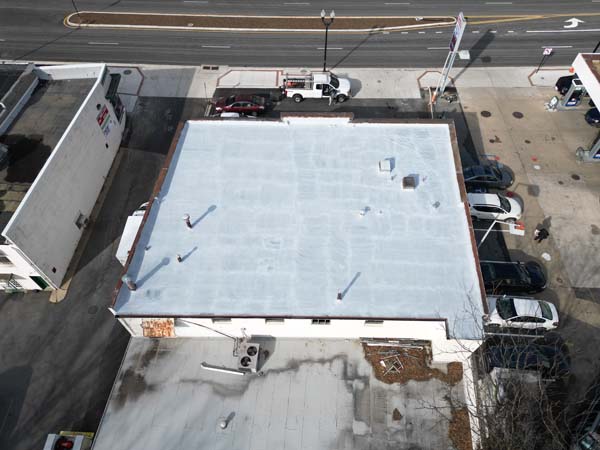

  6. 08/2026–09/2026 · Field coating

    High-solids silicone applied to 40 mils DFT

    PM Pro-Eco Sil HS 3200 Series high-solids silicone was applied in white across the full 7,306 square feet to a minimum of 40 mils dry film thickness, the thickness the 20-year system requires. Coverage was worked section by section with film thickness monitored as the work proceeded, so the specified thickness could be evidenced across the whole roof rather than averaged over it. The finished surface is seamless and highly reflective.

  7. 09/2026 · Closeout

    Manufacturer inspection and warranty issue

    Progressive Materials inspected the completed roof, which is a condition of the warranted system rather than a formality. The thickness record and photographic documentation were submitted with the inspection, and a 20-year labor and material warranty covering leaks due to silicone material failure was issued to the owner.

Measured Outcome

Results

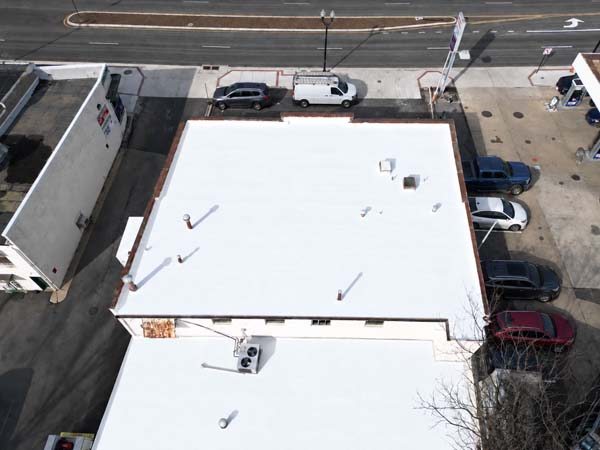

The warehouse has a seamless, white, fully warranted roof that now drains the way it was designed to. The gutter line is sound structure again rather than rotting wood under a membrane, the raised edge that had been damming water is gone, and the existing roof stayed on the building instead of going to landfill. At the end of the 20-year term the system is renewable with a recoat rather than a tear-off.

7,306 SF Restored Existing modified bitumen membrane retained as the substrate; no tear-off.
50 LF Gutter Line Rebuilt Rotted wood decking and framing replaced and the edge slope re-established.
40 Mils Minimum DFT PM Pro-Eco Sil HS 3200 Series applied in white to the 20-year system thickness.
20 Mil Seam Stripe Every lap seam striped approx. 2 in. wide before the field coating went down.
93% Solar Reflectivity Approximate reflectivity of the completed white silicone system.
20-yr PM Warranty Labor and material, covering leaks due to silicone material failure.

Verification & Documentation

The project record documents the structural condition found at the gutter line, the pre-restoration testing that established the rest of the roof was a valid restoration candidate, the repair work performed before coating, the coating thickness achieved, and the manufacturer inspection and warranty closeout. Records are retained and available to the owner on request.

  • Structural condition record — photographs and probe findings documenting swollen and rotted wood decking and framing across 50 LF of the gutter line, and the upward deflection of the roof edge that was damming water back onto the roof
  • Gutter-line reconstruction record — rotted decking and framing cut out and replaced with sound material, correct edge line and slope re-established, and the section reroofed into the existing membrane
  • Moisture survey — non-destructive survey completed across the full roof area before restoration, as required by the manufacturer, using a Tramex surface scan moisture meter and a Tramex CMEX5 digital moisture meter with 2-pin probe read in 8 separate areas of the roof, with wet areas mapped for replacement
  • Infrared thermographic scan — post-sunset scan with a HIKMICRO M30 Professional thermal imager, independently corroborating the areas of retained moisture identified by the moisture meters
  • Core sample record — full-depth cores cut at flagged areas to confirm the existing assembly and the extent of retained moisture, patched the same day
  • Wet area replacement — saturated material cut out and replaced before any coating was applied
  • Slope correction — PM Pro Slope installed at remaining ponding and low areas and PM SL 800 Surface Leveler applied at alligatored and heavily cracked areas
  • Cleaning record — full roof area power washed at a minimum of 2,000 PSI, rinsed, and dried before coating
  • Adhesion test — manufacturer-required adhesion test performed on the cleaned and dried surface and passed before the field coating was committed
  • Bleed-block primer record — PM P-160 Asphalt Bleed-Block Primer spray applied over the entire modified bitumen surface at 1 gallon per 100 SF, ahead of seam striping and field coating
  • Seam stripe record — 20-mil silicone stripe approximately 2 inches wide applied over all membrane lap seams at approximately 400 linear feet per gallon, ahead of the field coat
  • Reinforced repair record — 3-course silicone and polyester fabric repairs documented at all failed and open seams and at all flashing failures
  • Film thickness record — PM Pro-Eco Sil HS 3200 Series applied in white to a minimum 40 mils dry film thickness, recorded by section during application
  • Drainage verification — post-completion observation confirming the rebuilt gutter line carries water into the gutter rather than holding it at the roof edge
  • Manufacturer final inspection — Progressive Materials inspection of the completed system, required before the warranted system could be closed out
  • Manufacturer warranty — 20-year Progressive Materials labor and material warranty covering leaks due to silicone material failure, issued to the owner
  • Photographic record — existing conditions, gutter-line demolition and reconstruction, repairs and seam striping, and completed coating documented by roof area

Installed by GoTech Roofing — OSHA 30-Hour certified supervision with a designated Fall Protection Competent Person on site, and manufacturer-certified applicator status current at the time of installation. This project is the clearest possible illustration of why ponding has to be diagnosed rather than simply coated: the water standing at the roof edge was not a slope design error but the visible symptom of wood rotting away beneath the membrane. A coating applied over it would have looked like a finished roof, sealed the rot in, and left the dam in place.

Photographic Record

Evidence

Original project photographs taken by GoTech Roofing at 2330 Columbia Pike, in sequence: the weathered modified bitumen surface as found, the alligatoring and seam splitting that drove the repair scope, the adhesion, moisture and core testing that had to pass before any coating was committed, the bleed-block primer that keeps asphalt from yellowing a white roof, and the finished silicone system.

Who Did the Work

Project Team & Credentials

Site Supervision

All field crew members assigned to the project had completed OSHA 30-Hour Construction Safety training, with a designated Fall Protection Competent Person on site for the duration of the work.

Manufacturer Certification

GoTech Roofing held current manufacturer-certified applicator status at the time of the work, a condition of the Progressive Materials 20-year warranted system being issued on the completed roof.

Inspection & Reporting

GoTech Roofing commercial roof inspection staff documented the pre-restoration conditions, the structural deterioration at the gutter line, the Tramex moisture survey, the post-sunset HIKMICRO infrared thermographic scan, the core samples, the adhesion test, the repair and seam-striping scope, and the film thickness achieved. Progressive Materials performed the final inspection and warranty closeout.

Common Questions

Silicone Roof Restoration FAQ

These are the questions building owners and facility managers most often ask when an aged modified bitumen roof is leaking, ponding, or showing damage at the roof edge. Each answer explains the general principle so you can evaluate your own building's roof. More detail on our process is on the roof coatings page.

Can a modified bitumen roof be restored with a silicone coating instead of replaced?

Yes, when the assembly below the membrane is dry and structurally sound. Modified bitumen is one of the substrates silicone restoration is best suited to, because the existing membrane stays in place and becomes the base sheet for a new fluid-applied waterproofing layer. What determines eligibility is not the age of the roof but its condition: a moisture survey has to confirm the insulation is dry, any wet areas have to be cut out and replaced, and an adhesion test has to confirm the coating will bond to that specific weathered surface. Structural damage found during that assessment does not rule restoration out, but it does have to be rebuilt first rather than coated over.

Does a roof with two or more existing layers have to be torn off?

Yes, and because the restriction appears in both model codes, the correct citation depends on what kind of building it is. For one- and two-family dwellings and townhouses, the residential provision is 2018 IRC Section R908.3, which governs roof replacement and does not permit a roof recover where the existing roof already has two or more applications of any type of roof covering. For commercial buildings and most multi-family residential construction, the equivalent commercial provision is 2018 IBC Section 1511.3. The effect is the same under either code: where a roof already carries two or more layers, for example modified bitumen installed over an existing built-up roof, a new roof covering cannot legally be installed over the top, and the existing layers have to be removed down to the deck first. That turns a traditional re-roof into a mandatory full tear-off, which is the most expensive and most disruptive part of any roofing project: it is noisy and dirty, it exposes the interior to weather, and in a working building it is the part that interferes most with operations. A silicone restoration is not a new roof covering installation, so the two-layer restriction does not force a tear-off. The existing layers stay on the building and are waterproofed with a fluid-applied coating instead. This project is a warehouse, so the IBC provision is the one that applies.

What happens when the wood decking at a roof edge rots from a long-term leak?

It has to be rebuilt, and the damage is usually worse than it looks from above. Water that gets past the membrane at a roof edge keeps the wood decking and framing beneath it permanently wet, and the wood swells, softens, and eventually loses its structural strength. As it deteriorates it also loses its shape, so the roof edge no longer sits where it was built to sit. That is a structural repair, not a roofing repair: the membrane is opened up, the rotted decking and framing are cut out and replaced with sound material, the correct line and slope are re-established, and only then is the area reroofed and brought into the coating system.

Why would a roof pond with water right next to the gutter?

Because the edge of the roof has risen relative to the field behind it. When the wood structure along a gutter line rots and swells from prolonged leakage, the deck can deflect and curl upward at the edge, forming a lip. That lip acts as a dam: water running down the roof reaches it and stops instead of spilling into the gutter, so it stands in a band along the roof edge. It is a self-worsening condition, because the water that now sits against the edge keeps the rotting wood wet and the lip keeps growing. Coating over it would seal the surface but leave the dam in place, so the structure has to be rebuilt and the slope re-established first.

What is a silicone roof restoration?

A silicone roof restoration is a fluid-applied waterproofing system installed over an existing low-slope roof rather than replacing it. The roof is power washed, repaired, and detailed, every membrane lap seam is reinforced with a silicone seam stripe, failed seams and flashings are rebuilt with reinforced three-course repairs, and a high-solids silicone field coating is then sprayed or rolled over the entire roof to a specified dry film thickness. The result is a seamless, highly reflective membrane that is renewable at the end of its warranty term rather than being torn off and landfilled.

Why does a modified bitumen roof need a bleed-block primer before silicone coating?

To keep the asphalt from discoloring the coating. Chemicals bleed out of an asphalt roof surface and migrate up into the silicone above it, turning a white coating yellow. Progressive Materials P-160 Asphalt Bleed-Block Primer is a single-component, water-based, plasticizer-free acrylic primer designed for smooth asphalt roof surfaces, and it forms a barrier between the asphalt and the silicone that stops that bleed-through. On a Progressive Materials modified bitumen system it is applied over the entire asphalt surface at one gallon per 100 square feet before any silicone goes on. It can be sprayed, brushed, or rolled, and spray application is preferred.

What is a silicone seam stripe and why is it applied before the field coating?

A seam stripe is a heavier band of silicone applied over every membrane lap seam before the field coating goes down. On a Progressive Materials system it is applied at 20 mils and roughly two inches wide, at a coverage rate of about 400 linear feet per gallon. Laps are where a modified bitumen roof moves and where water finds its way in first, so building extra thickness there before the field coat means the most vulnerable line on the roof carries more material than the field, not less. Skipping the stripe leaves the seams at field thickness and is one of the most common reasons a coating fails early.

What is a three-course repair on a roof?

A three-course repair is a reinforced detail built in three passes: a base layer of silicone, a layer of polyester reinforcing fabric embedded into it while wet, and a second layer of silicone over the top that fully encapsulates the fabric. The fabric gives the repair tensile strength and bridging ability that coating alone does not have, which is why it is specified at failed or open seams, at flashing failures, and at penetrations and curbs. Any area that has already moved or split is repaired this way rather than simply being coated over.

How thick does a silicone roof coating have to be for a 20-year warranty?

For a Progressive Materials 20-year system over modified bitumen the field coating must achieve a minimum of 40 mils dry film thickness, and the 20-year color option is white only. Thickness is what drives warranty term on a silicone restoration: shorter warranty terms are written at lower dry film thicknesses and longer terms require more material on the roof. Because the requirement is a dry film thickness, application has to be logged and verified as the work proceeds, and the manufacturer inspects the completed roof before the warranty is issued.

Why is a moisture survey required before a roof restoration?

Because a coating is a vapor-retarding layer, and any water already trapped in the assembly stays trapped underneath it. Wet insulation loses its R-value, rots a wood deck or corrodes a metal one, and will push against the new coating as it tries to escape, which can blister or disbond the system. A non-destructive moisture survey maps where the assembly is wet so those areas can be cut out and replaced before any coating is applied. It is also a manufacturer requirement, not just good practice, on a warranted restoration system.

What is an adhesion test and why is it done before coating a roof?

An adhesion test confirms that the coating will actually bond to the specific roof it is being applied to. A small area is cleaned and dried exactly as the full roof will be, a sample of the coating is applied, and once cured it is checked for bond. Aged roof surfaces vary enormously depending on the original product, how weathered they are, and what has been applied over them previously, so the test is performed on the actual roof after cleaning rather than assumed from the data sheet. It is required after cleaning and drying and before the field coating is committed to.

Can ponding water be corrected without tearing off the roof?

Yes, provided the cause is addressed rather than the symptom. Where the slope is simply inadequate, low areas can be built back up with a pourable or trowel-applied slope compound such as Progressive Materials Pro Slope, installed in the low spots and feathered out into the surrounding field so water is carried to the outlets instead of standing. Heavily alligatored or cracked areas are filled and smoothed with a surface leveler such as PM SL 800 so the silicone has a sound, continuous surface to bond to. Where the ponding is caused by structural deterioration rather than original design, that structure has to be rebuilt first, because no amount of slope compound will fix a roof edge that has physically moved.

Can a warehouse stay in operation during a roof restoration?

In most cases yes, and that is one of the main practical advantages of restoration over replacement. Because there is no tear-off, the existing membrane is never opened, so there is no point at which the interior is exposed to weather, no tear-off debris to move through or around the building, and no need to protect stored goods or racking from an open roof. Localized structural repairs are the exception and are staged and dried in area by area. Access, staging, and any temporary interruption to rooftop equipment are coordinated with operations, and loading dock and yard traffic is kept clear of the work zone.

What does a 20-year Progressive Materials silicone warranty cover?

The 20-year Progressive Materials system carries a 20-year labor and material warranty covering leaks caused by failure of the silicone material, subject to the warranty terms and exclusions. It requires the system to be installed to the published specification, including the minimum 40 mil dry film thickness, white coating, seam striping, and reinforced repairs at failed seams and flashings, and it requires a manufacturer inspection of the completed roof before the warranty is issued. That final inspection is the step that converts a completed coating job into a warranted roof system.
